13 Min Read
Kitchen Remodel Cost and Timeline in Lansing, MI
Our Tacoma Hills kitchen in Okemos was back in use about 23 weeks after the first design meeting. Construction took about 10 to 11 of them. The rest went to design, picking every finish, and waiting on cabinets, while the old kitchen still worked.
Most online answers related to kitchen remodeling timelines skip those first twelve weeks entirely, and they're off on cost in the same way. The number Google gives for a Lansing kitchen is often half of what a mid-range kitchen runs here, because it leaves out design, permits, and the work behind the walls. Here are both numbers, cost and time, the way they actually play out in Greater Lansing homes.
In this blog you'll learn what a Greater Lansing kitchen remodel costs at each level, how long each phase takes, how long five real Odd Fellows Contracting kitchens took, and when to start for your target date.
About the author
Mark Dixon is a Designer and Project Estimator at Odd Fellows Contracting in Greater Lansing, MI. He's an NKBA Certified Kitchen and Bath Designer (CKD) and NARI Certified Remodeler (CR), and he designs and prices kitchens for homeowners across Lansing, Okemos, East Lansing, and Williamston.
▶ Watch: one Okemos kitchen in 45 seconds. From the first design meeting to the finished kitchen, with the real dates, plus what kitchens cost around Greater Lansing.
Find your start date with the planner ↓
Table of Contents
How Much Does a Kitchen Remodel Cost in Lansing, MI?
A kitchen remodel in Greater Lansing costs $18,000 to $145,000+, depending on which of three levels your project falls into.
Those ranges come straight from our remodeling cost guide, and they're built from kitchens we've designed and built around Greater Lansing. Every range includes 3-D design, permit pulling, inspections, labor, and construction materials. That last part matters, and we'll come back to it.
| Level | Typical investment | What it usually includes |
|---|---|---|
| Refresh | $18,000 to $65,000 | Paint, refaced or refinished cabinets with new hardware, standard appliances and fixtures, laminate or prefabricated countertops, sheet vinyl or standard luxury vinyl flooring |
| Mid Range | $65,000 to $110,000 | Layout often modified, semi-custom soft-close cabinetry, granite or quartz countertops, tile backsplash, upgraded appliances and flooring, changes to electrical, plumbing, and HVAC |
| Luxury | $110,000 to $145,000+ | Complete layout change, custom cabinetry throughout, top-of-the-line appliances, upgraded stone countertops and backsplash, hardwood or premium-pattern tile, extensive mechanical work |
Want a number for your own kitchen? The estimator below asks a few questions about your home and the kind of kitchen you want, then gives you a planning range based on projects we've actually built.
Estimate Your Kitchen Remodel
Answer a few questions and we'll show you a realistic range based on projects we've actually built around Greater Lansing. It's an estimate to help you plan, not a quote. The most accurate number comes from a conversation with our team.
What are you planning?
What kind of project are you thinking about?
About how big is your home?
Enter a home size between 400 and 15,000 square feet.
Most homes we remodel around Greater Lansing run 1,200 to 3,500 square feet. If you aren't sure, your county assessor listing usually has it.
About how big is the space?
What level of finish are you after?
Does the project involve moving walls or structural changes?
How much work does the existing space need?
Your estimated investment
-
Where the money typically goes
This is a planning range, not a fixed price. Once we walk your home and talk through your goals, we put a fixed price in writing before any work starts.
Every home is different. The age of the home, structural changes, and the materials you pick all move the number. The best way to get a real figure is a conversation with our team.
These ranges include design, permit pulling, inspections, labor, and construction materials. Larger projects like whole home remodels and additions also include design development and jobsite management. Appliance and furniture allowances vary by project.
Refresh ($18,000 to $65,000)
A refresh keeps your layout and gives the room a new face.
This is the right fit when the kitchen works, it just looks tired. Cabinets get painted or refaced, counters and appliances get replaced, and the plumbing and electrical stay where they are. Keeping things in place is what keeps the cost down.
Our Candlewood Estates kitchen refresh is a good example. The size and layout worked, so the homeowners kept the layout and flooring, refaced the cabinets with new doors and drawers, added brighter quartz countertops and a new subway tile backsplash, and improved the lighting. Because the plumbing, HVAC, and electrical stayed in the same locations, they saved significant money compared with a full remodel. If you're stuck between the two, our guide to kitchen refresh vs. remodel walks through how to decide.
Mid Range ($65,000 to $110,000)
Mid Range is where most full kitchen remodels around Lansing land, and where the layout usually starts to change.
New semi-custom cabinets, stone counters, tile, and real changes to plumbing, electrical, and HVAC. This is also the level where we see the most common request in our inbox: take out a wall, lose the peninsula, or borrow space from the room next door.
On the Tacoma Hills kitchen in Okemos, we removed the peninsula and the cabinets blocking the dining nook to open the space, which meant updating the plumbing, electrical, and HVAC. The homeowners got two-tone cabinets, a window bench with extra storage, and new flooring through the kitchen, dining area, and the bathroom next to it.
Luxury ($110,000 to $145,000+)
Luxury means the whole room is redesigned, with custom cabinetry and premium finishes throughout.
At this level the layout changes completely, the cabinets are built for your space, and the mechanical work is extensive. It's less common in Greater Lansing than the first two levels. Homeowners here tend to remodel for a kitchen that finally works the way they live. When the goal is a kitchen you'll cook in for the next twenty years and the structure supports it, this is the level that gets you there.
Why Online Kitchen Cost Estimates Run Low
Most online kitchen numbers for Lansing come from national cost databases built on per-foot rates.
If you've searched around, you may have seen a "Lansing average" in the $20,000s or $30,000s. Those figures are usually built from per-foot material and labor rates. They often leave out the parts that turn a pile of cabinets into a finished kitchen:
- Design. Layout, 3-D drawings, and every selection made before anything gets ordered.
- Permits and inspections. Pulling them, scheduling them, and passing them.
- The work behind the walls. Old wiring, plumbing, framing, and insulation that a 1970s house needs brought up to date once it's open.
- Someone running the job. Scheduling a dozen trades in the right order so the countertop template doesn't show up before the base cabinets.
Our ranges include design, permits, inspections, labor, and materials. That's why they look higher than a database average and why they hold up once the project starts. Other Greater Lansing design-build firms that publish real project numbers land in the same range for a medium-size kitchen.
A low number isn't a cheaper kitchen. It's usually a number that leaves things out, and those things show up later as change orders.
What Drives the Cost of a Kitchen Remodel
Five things move a kitchen budget more than anything else: layout, cabinets, materials, the age of the house, and the rooms around the kitchen.
Layout changes
Moving walls, plumbing, or appliances has the biggest single effect on cost.
It's also the thing people ask us for most. "Knock out two walls to open the kitchen." "Bump out a wall to expand." "Can this wall move or shrink?" Every one of those is doable, and every one changes the scope. A sink that stays put costs far less than a sink that moves across the room with new drain lines, venting, and a floor that has to be opened to get there.
Cabinets
Cabinets are usually the largest single piece of a kitchen budget.
Refaced, semi-custom, or fully custom makes a big difference, and so does the box construction and finish. Cabinets are also the part with the longest lead time, which matters for your schedule as much as your budget.
Material selections
Every selection adds up: countertops, tile, flooring, fixtures, lighting, and appliances.
Laminate countertops cost a fraction of what quartz or granite does. A standard tile pattern installs faster and costs less than a premium pattern. None of these choices is wrong. Each one moves the number, which is why we price your actual selections instead of guessing at allowances.
The age of your home
Older Greater Lansing homes often need updates you can't see until the walls are open.
Outdated wiring, old plumbing, and framing or insulation problems are common in houses built before the 1980s. On one Lansing kitchen, part of the plan was fixing existing framing and insulation problems while we were in there. Older homes can also turn up mold, lead, or asbestos that needs remediation. It's better to plan for it than to be surprised.
Adjacent spaces
A kitchen remodel rarely stops at the kitchen doorway.
New flooring usually needs to run into the dining room or hallway so the floors match. Opening a wall changes the room on the other side too. On our Maple Shade kitchen in Williamston, the new flooring ran through the kitchen, dining area, family room, and garage entry.
How Long Does a Kitchen Remodel Take?
Construction on a kitchen remodel takes 8 to 12+ weeks, and the whole project takes roughly 18 to 29+ weeks from your first design meeting to the final walkthrough.
There are two clocks, and most online answers only give you one. Construction time is how long your kitchen is torn up. Total time includes design, selections, ordering, and permits, all of which happen before anyone swings a hammer. Here's how the full timeline breaks down at Odd Fellows Contracting, using the same phases from our Lansing remodeling timelines guide:

| Phase | Typical length | What happens |
|---|---|---|
| Initial consultation | About 1 hour | A phone call, then an in-home visit to talk through your goals and budget |
| Phase 1 Design | 3 to 4 weeks | Your space is scanned, then 3-D concept drawings and an initial budget |
| Phase 2 Design Development | 3 to 5 weeks | Material selections, a team meeting at your home, the final review, and a signed contract |
| Pre-Production | 4 to 8+ weeks | Ordering special-order materials, final plans, permits, and scheduling |
| Construction | 8 to 12+ weeks | Demolition through final walkthrough, with inspections along the way |
Phase 1 Design (3 to 4 weeks)
Phase 1 turns your ideas into a layout and a first budget.

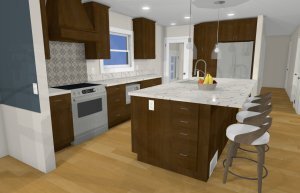

We photograph and digitally scan the kitchen, then meet with you to confirm key dimensions and talk through what you need from the space. It ends with a meeting at our Williamston showroom where you see 3-D concept drawings and an initial budget estimate.
Phase 2 Design Development (3 to 5 weeks)
Phase 2 is where every choice gets made, so nothing is left to guess about later.
You'll pick cabinets, counters, tile, fixtures, and lighting with your designer, and see how each choice affects the budget as you go. Your project foreman and the trades walk the space with us during a team meeting at your home. When every detail is set, you review the full project and sign a fixed-price contract.
Pre-Production (4 to 8+ weeks)
Pre-Production is mostly waiting on materials, and cabinets usually set the pace.
We order special-order items, finalize the building plans, and submit for permits. Cabinets and flooring commonly have lead times of 6+ weeks, so we schedule your start date around when they'll arrive. Starting construction before the cabinets are here is how kitchens end up sitting half-finished.
Construction (8 to 12+ weeks)
Construction is the stretch when your kitchen is out of commission, and it's typically 8 to 12+ weeks.
A pull-and-replace kitchen takes significantly less time than one where we're moving walls, plumbing, and mechanicals. Permits and inspections are part of this phase and can add 2 to 3+ weeks on their own. You'll have a client portal with your start date, end date, and the major work scheduled along the way.
Why put so much time up front? In our experience, more time spent in design means less time spent in construction. When a remodel drags on, it's almost always because something wasn't decided or planned before the work started.
How Long Five Real OFC Kitchens Took
Five recent Odd Fellows Contracting kitchens took 19 to 29 weeks from the start of design to a fully working kitchen.
These dates come from each project's page in our kitchen portfolio. Construction time runs from the day work started in the home until the kitchen was fully functional, so it includes permits and inspections. A few small punch-list and warranty items wrapped up after that, by the date in the last date column.
| Project | Design started | Construction started | Punch list wrapped | Construction | Start to working kitchen |
|---|---|---|---|---|---|
| Candlewood Estates Kitchen Refresh | Jul 17, 2024 | Oct 21, 2024 | Nov 27, 2024 | About 5 weeks | About 19 weeks |
| West Lansing Kitchen Remodel | Oct 21, 2024 | Jan 27, 2025 | Apr 21, 2025 | About 10-11 weeks | About 24-25 weeks |
| Maple Shade Williamston Kitchen Remodel | Nov 5, 2024 | Jan 25, 2025 | May 15, 2025 | About 10-11 weeks | About 22-23 weeks |
| Tacoma Hills Okemos Kitchen Update | Mar 25, 2025 | Jun 20, 2025 | Oct 15, 2025 | About 10-11 weeks | About 22-23 weeks |
| Lansing Westside Kitchen Remodel | Apr 4, 2025 | Aug 5, 2025 | Dec 5, 2025 | About 10-11 weeks | About 28-29 weeks |
What the dates show:
- A refresh moves fast once it starts. Candlewood kept its layout, and construction took about five weeks.
- Layout changes add weeks. West Lansing removed an unused half bath to lengthen the kitchen. Tacoma Hills removed a peninsula and updated the plumbing, electrical, and HVAC. Lansing Westside extended into the nook, moved the range to an outside wall for proper ventilation, and fixed existing framing and insulation problems. More scope means more construction time, and these four were fully functional at about 10 to 11 weeks.
- Plan around the total. Every one of these kitchens took between four and seven months from the first design meeting to a working kitchen. If you're planning around a holiday, a graduation, or a move-in date, count from the start of design, not the start of construction.
What Can Stretch Your Cost and Timeline
Two things push a remodel past its planned finish date: changes after the contract is signed and conditions nobody could see until the walls were open.
- Changes you request mid-project. It's common for a new idea to come up once the cabinets are going in, like an extra outlet on a wall. We'll show you the cost and schedule impact before we make any change, so you decide with real numbers. Some changes barely touch the schedule. Others move it.
- Surprises behind the walls. Every house has some unknowns. Wiring that doesn't meet code, plumbing in odd places, and the work of a previous handy homeowner are the usual suspects. If we find something, we'll explain the impact and your options right away.
- Material lead times. Special-order cabinets and finishes can take longer than expected. Making every selection before the contract, and ordering before demolition, is how we keep this from stalling your kitchen.
- Inspection backlogs. They've lengthened some projects lately and are outside anyone's control, which is one more reason the construction range ends in a plus sign.
How long does it take to rip out and replace a kitchen?
A pull-and-replace kitchen, where everything stays in the same spot, takes significantly less construction time than a remodel that moves walls or plumbing.
The Candlewood refresh above is a useful reference. It kept its layout, and construction took about five weeks. The design, selection, and ordering phases still happen first, so plan for a longer total timeline even when the build itself is quick.
Want a New Kitchen by Summer? Start This Winter
To use a new kitchen by early summer, most homeowners need to start design over the winter.
Count backward from the date you want the kitchen done. With 8 to 12+ weeks of construction and about 10 to 17+ weeks of design, selections, and ordering before it, an early-summer finish means sitting down for design around the holidays. The good news is that all of the planning happens while your current kitchen still works.
Use the planner below to see when your project needs to start.
When Should You Start Your Kitchen Remodel?
Pick the month you want your new kitchen done. We'll count back through each phase to show when design needs to start.
Based on Odd Fellows Contracting's published remodeling timelines. Cabinet lead times, permits, and inspections can add time. You get your actual schedule before construction starts.
How OFC Plans and Prices Your Kitchen
Odd Fellows Contracting uses a 6-step design-build process that does the planning first, so you know your price and your schedule before construction begins.
- Initial Consultation and Planning. A phone consultation, then an in-home consultation to review your space and answer your questions.
- Pre-Construction Planning. Measurements, structural considerations, feasibility, and a preliminary budget.
- Design and Selections. 3-D renderings and every material choice made at our Williamston showroom, all tied to your budget.
- Fixed Pricing and Agreement. A fixed-price contract based on real selections and detailed plans. No vague estimates and no allowances that grow later.
- Construction Begins. A dedicated project lead, a clean job site, and a clear schedule.
- Completion and Follow-Through. A final walkthrough, a professional cleaning, and follow-ups at 6 and 12 months to make sure you still love your space.
Design is built into the process with no separate fee, and every required permit is included in your proposal. As a licensed remodeling contractor, we file the permits and schedule the inspections with your local jurisdiction. We've been remodeling Greater Lansing homes since 1988, and our kitchen designers include an NKBA Certified Kitchen and Bath Designer. You can see the full breakdown on our Our Process page or learn more about kitchen remodeling with OFC.
Kitchen Remodel Cost and Timeline FAQ
How much does a kitchen remodel cost in Lansing, MI, and how long does it take?
A kitchen remodel in Greater Lansing costs $18,000 to $145,000+ and takes about 18 to 29+ weeks from the first design meeting to completion. Construction itself is typically 8 to 12+ weeks. Refreshes run $18,000 to $65,000, Mid Range remodels $65,000 to $110,000, and Luxury remodels $110,000 to $145,000+.
How long does a kitchen remodel take?
Construction typically takes 8 to 12+ weeks. Design, selections, ordering, and permits add roughly 10 to 17+ weeks before construction starts. Five recent OFC kitchens took 19 to 29 weeks from the start of design to a working kitchen.
How much does it cost to redo a kitchen in Michigan?
In Greater Lansing, OFC's kitchen remodels range from $18,000 for a refresh to $145,000+ for a full luxury redesign, with design, permits, inspections, labor, and materials included. Costs elsewhere in Michigan vary with local labor rates and the age of the housing.
Is $20,000 enough for a kitchen remodel?
Yes, at the Refresh level, which starts at $18,000. That typically covers paint, refaced or refinished cabinets, new standard appliances and fixtures, and laminate or prefabricated countertops while keeping the existing layout. Moving walls or plumbing takes the project into the Mid Range level.
Is $10,000 enough to update a kitchen?
That budget usually fits a smaller kitchen update. Our Odd Jobs handyman team takes care of smaller kitchen improvements like new cabinet hardware, fixtures, lighting, and trim repairs. See kitchen updates from Odd Jobs for what's included.
What's the most expensive part of a kitchen remodel?
Cabinets are usually the largest part of the budget. Moving walls, plumbing, or appliances is the biggest factor in total project cost, because it changes the scope of work for nearly every trade.
Can I remodel my kitchen in stages to save money?
It depends on the project, though we don't usually recommend staging a full kitchen remodel. Kitchen updates can be done in stages if you're keeping your existing cabinets.
Are design and permits included in the price?
Yes. As a design-build contractor, design is part of the process at no added cost. All required permits are included in your proposal, and we schedule the inspections.
Will I know the exact price before work starts?
Yes. Once your selections and plans are final, you'll get a fixed-price contract before any demolition begins.
Can I use my kitchen during the remodel?
Usually not during construction, so plan for 8 to 12+ weeks without it. Most families set up a temporary kitchen with a microwave, coffee maker, and a small fridge in another room. Planning a few simple meals ahead makes the stretch much easier.
Know Your Number and Your Dates Before You Start
A kitchen remodel goes well when you know two things before construction begins: what it's going to cost and when it's going to be done.
Wouldn't it be odd to know your price and your finish date before demo day? That's how Odd Fellows Contracting builds every kitchen. We plan it, price it, and schedule it before we start, so you aren't left guessing at either answer halfway through.
If you're planning a new kitchen for next year, this winter is the time to start. Tell us about your kitchen, and we'll set up your initial consultation.
Not ready to talk yet? Download our remodeling cost guide or browse our kitchen portfolio. Still choosing a look? Our 2027 kitchen trends post has a quick quiz. Remodeling a bathroom too? We broke down bathroom remodel cost and timeline the same way.
